Measured work. Clear drawings. On-spec delivery.

Murphy Prime Construction plans, coordinates, and installs building systems for owners who want one accountable team.

Company profile
Geometric white building facade

Building systems

Mechanical, electrical, and plumbing under one contract.

HVAC, power, plumbing, and controls coordinated against the architectural set before fabrication starts.

See the scopes
Large contemporary commercial building

Design-build

From schematic layout through installation and close-out.

Owner reviews sit at design freeze, procurement, and pre-balance. The project file stays with the job.

Project index
Open contemporary commercial structure

Engineering & technology

Build it once in the model. Then build it on site.

BIM, virtual reality, laser setting-out, photogrammetry, and 4D simulation sit inside the same delivery team.

Engineering practice

The firm

A privately held engineering and contracting practice. Not a catalog of borrowed project photos.

Founded in 2001 by civil engineer Daniel Murphy after a career at Bechtel. The office is at 4221 Wilshire Boulevard. Typical work is mechanical, electrical, and plumbing packages, design-build interiors, site utilities, and system upgrades in occupied buildings.

About Murphy Prime

Architecture photography is visual context. Inclusion does not represent a project credit.

0Year the practice was established
0Service lines, from data centres to operations
1Accountable principal, Daniel Murphy
LAOffice No. 1111, Wilshire Boulevard

How a package moves

Six gates, one model.

01

Scope

Written division of work before a full estimate is opened.

02

Model

Revit MEP coordinated with architecture, structure, and the prefabrication set.

03

Off site

Modules drawn in-house and built before they reach the floor.

04

Set-out

Robotic stations place hanger points from the model, not from a tape.

05

Install

A trained module crew sets plant and distribution in the planned sequence.

06

Operate

The same model carries commissioning, snags, and the operations handover.

Geometric building facade used as a delivery study

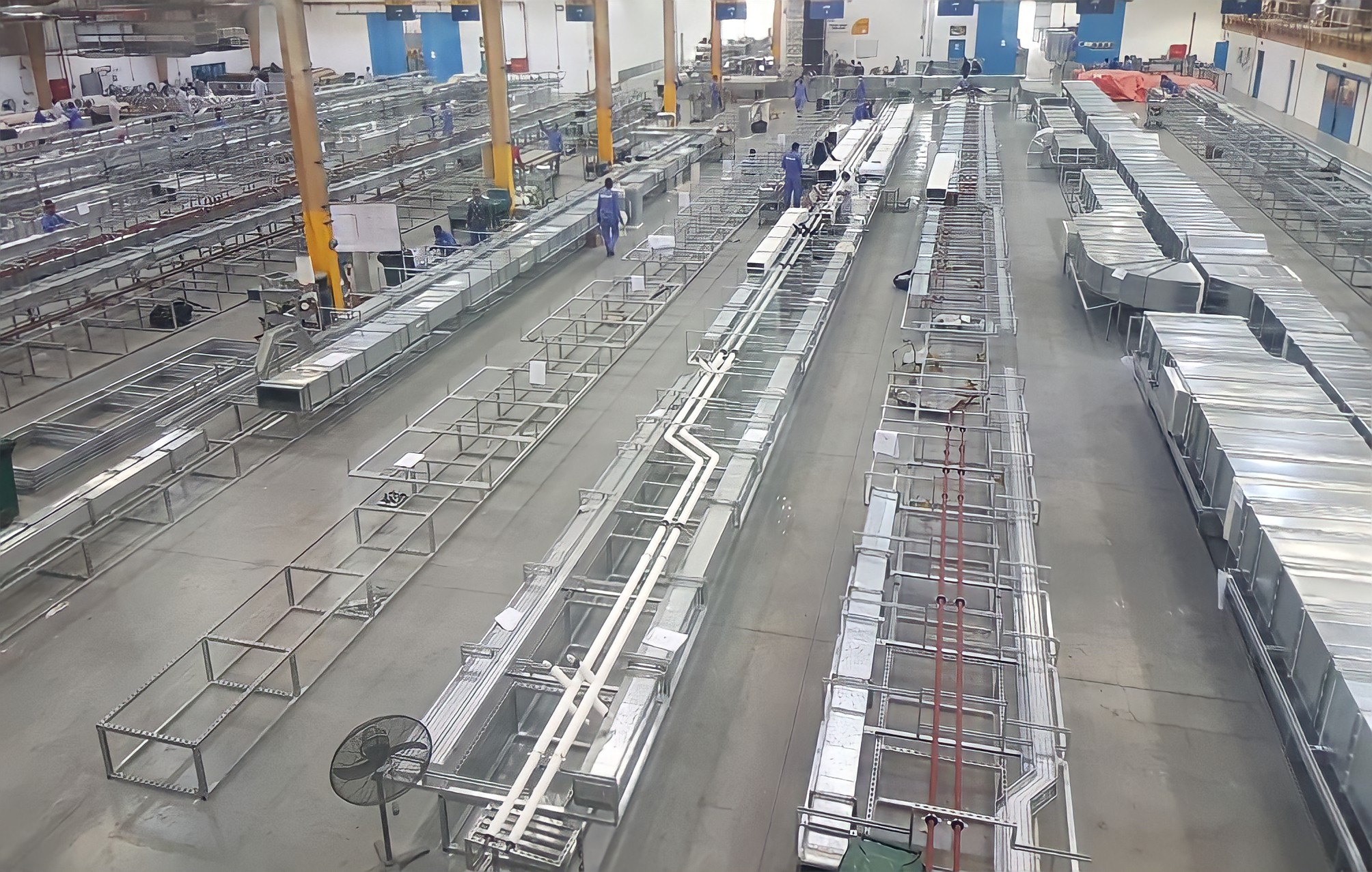

Off-site manufacturing

About 70% of first and second fix MEP distribution can leave the floor.

On data centre work, Murphy Prime prefabricates distribution so handover comes earlier. Since 2015 the practice has produced more than 40,000 MEP modules, each generated in Revit and coordinated with the shop-drawing model. Historical rates show roughly 40–60% fewer installation hours than conventional stick-build.

Prefabrication

Questions we hear

Why an MEP contractor as the lead on a data centre?

A data centre is an MEP project. Civil and architectural work houses the equipment. When the MEP contractor leads, long-lead plant, milestones, and modular design drive the programme instead of sitting behind a civil subcontract.

What does design-build change for the owner?

The package can be awarded early against a budget. Murphy Prime advises whether the number is real, and the owner is not left paying for design gaps that appear after a build-only award.

How does the model survive into operations?

One BIM model runs from design through shop drawings, prefabrication, and handover. Clash detection happens while the design is still open, and the operations team inherits equipment sizes that match what was installed.
